Ijraset Journal For Research in Applied Science and Engineering Technology
Authors: Pranav Mhaisdhune, Madhura Aher
DOI Link: https://doi.org/10.22214/ijraset.2023.52900
Certificate: View Certificate
The aim of the study is to show how fleet management can help in saving time and cost by comparing the current onsite equipment to optimised results. The detailed study of fleet of equipment and their related parameters and specifications is important because it helps to determine requirement of equipments for a particular activity. All the cost including labor, maintenance, operating costs, machine capacity were considered to find out the productivity as well as expenses. Based on the site visit and data collection various parameters such as productivity of excavator, production rate, cycle time and other parameters of activities such as earthmoving equipment, hauling of trucks as well as productivity of paver were also calculated. The parameters were obtained for various combinations of different truck sizes as shown in the MS- Excel sheet. For different truck sizes and different combinations we get different cost index.
I. INTRODUCTION
Fleet operation is the system which uses operation or technology to track and manage different kinds of vehicles similar as buses, weight logistic assignment, luxury motorcars, ambulance assignment, vessels etc. The fleet management system also keeps records of vehicles similar as purchase, reimbursement or parcel information, motorist records, energy information, GPS records and so on. Private builders and trace drivers are also enforcing major systems. numerous of moment's large- scale systems calculate on a line of heavy- duty vehicles and means pavers, excavators, tractors, bulldozers, backhoes, cranes, you name it - each vehicle within the line has a specific use case and serves a unique purpose in support of operations and during a construction design.
A. Need of the study
In construction industry construction management is important in operation of equipments as per the operations carried out. Price hike in fuel and energy in last many years has become a reason for need of proper fleet management. The detailed study of machines i.e fleet and their affiliated parameters and specifications is important because it helps to determine demand of equipment for a particular exertion e.g. DBM, earthwork activity. This kind of management not only saves the cost but also helps in optimizing time.
B. Objectives
II. REVIEW OF LITERATURE
Some theoretical and analytical investigations performed in this field are presented in the following literature survey.
III. METHODOLOGY
At present case it has been observed that there was unplanned management of the equipments. The data was obtained from Monthly Progress reports as well as site study from engineers and workers on the site. Study of equipment as well as site visit was done to analyse the data and a model was developed by using Saeed Karshena truck loader and R.L Peurifoys construction planning and methods. The model was used for calculations on M.S excel.
IV. RESULTS ANALYSIS AND DISCUSSIONS
In the current case the hot mix plant is located at Pimpalwadi which can produce about 160 tons per hour. Chainage is 29.00 to 30.00 and the distance between actual site and hot mix plant was about 9 km to and fro. The project was requiring a paving individual 12.5 m lane of 1 km and 115mm thickness having a density of 2.45 tonnes/cum. The maximum speed of paver is about 15m per minute. Efficiency of Asphalt paver is 0.8 and density of 2453 kg/sq.m-m.
Operational cost of paver is Rs. 8000 per hour and total cost of various associated labors is Rs. 3500 per day. In the case study the trucks are variable in sizes as they are rented for the whole duration of project. As there are various costs associated with the equipments, there is a need to select best equipment mix best fleet that will improve the productivity and satisfy the constraints of the project.
Table 1. Data collection for DBM fleet
Sr. No. |
Description |
Unit |
Quantity |
1 |
Capacity of Hot Mix Plant |
TPH |
160 |
2 |
Efficiency factor of HMP |
- |
0.9 |
3 |
Paving length |
km |
1 |
4 |
Width of road |
m |
12.5 |
5 |
Paving thickness |
mm |
55 |
6 |
Distance between site and HMP to and fro |
km |
9 |
7 |
Density of asphalt concrete |
kg/m3 |
2453 |
8 |
Operational cost of HMP (including diesel) |
Rs./hr |
8000 |
9 |
Paved density to be achieved |
kg/m2 |
1300 |
10 |
Delay estimates for paver |
min/cycle |
1.5 |
11 |
Efficiency factor of paver |
- |
0.8 |
12 |
Average slope |
- |
0.85 |
13 |
Swell factor |
- |
0.9 |
14 |
Max. velocity of paver |
mtr/min |
15 |
15 |
Gradient |
- |
0.3 |
16 |
Delay for dump trucks |
min |
4.5 |
17 |
Max. speed of tamper bar screed paver |
kmph |
15 |
18 |
Operational cost of paver (including diesel) |
Rs./hr |
5000 |
19 |
Operational cost of driver of paver (including lunch) |
Rs./day |
3900 |
20 |
Total daily working hours |
hrs |
8 |
21 |
Total working shifts |
- |
2 |
22 |
Delay cycle elements for dumper |
min |
5.5 |
23 |
Rolling resistance |
- |
3 |
24 |
Max. velocity of dumper |
- |
40 |
25 |
Plant capacity |
tonnes/min |
2.67 |
26 |
Labor cost of dumper driver (including lunch) |
- |
650 |
27 |
Capacity of Hot Mix Plant |
m3/hr |
65.23 |
28 |
HMP Operator cost |
Rs./day |
650 |
29 |
Quantity per m |
m3 |
0.6875 |
30 |
Quantity |
tonnes |
1.6864 |
31 |
Basic Diesel cost |
Rs./lit |
96.00 |
32 |
Quantity required for paving 1km |
m3 |

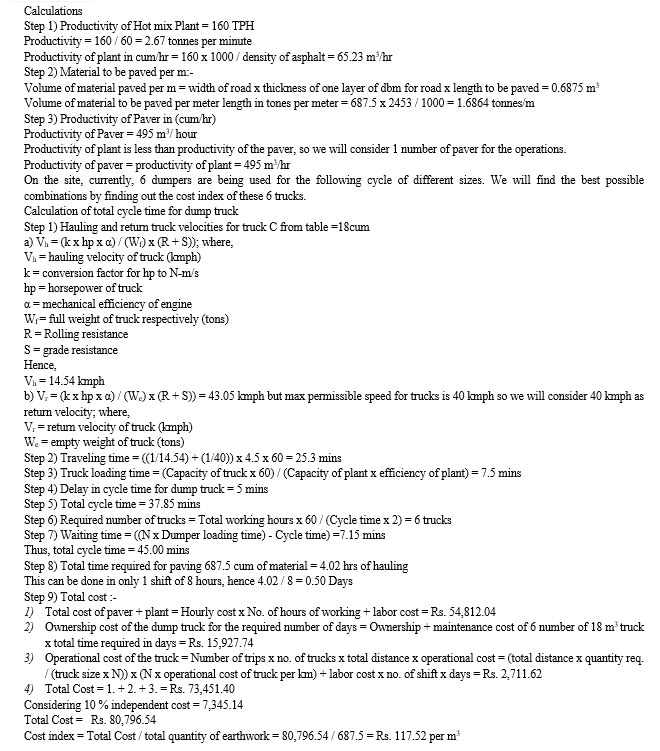

687.5 |
The factual on point line composition is grounded on the assumed thumb rules and no special optimization ways are employed and also the figures of units employed won’t with their maximum productivity. From the result and discussion, we conclude that, the mix possibilities of equipments give economical and profitable solution as per site condition. The parameters similar as cycle time, total cost, Cost indicator, total time needed for completing exertion are determined easily. Grounded upon the comparison of values, mentioned in an irregular format, in result chapter are as follows, 1) In earthwork fleet- Actual time required is 118.28 days whereas optimized time is 83 days. Actual cost index is Rs. 78.56 per m3 and optimized cost index is Rs. 67.24 m3. So the profitability is Rs. 16,97,818 which is achieved. 2) Paver (DBM) fleet- Actual cost index is 143.94 Rs/cum and optimized cost index is Rs. 117.52 m3. So the profitability is Rs. 18,164 which is achieved. The parameters such as cycle time, total cost, Cost Index, total time required for completing activity will be changed as per site conditions. The limitation of this study is, only two constructions activities are considered for this case study to analyze the data for actual distance. However, we can change the parameters and easily calculate more profitable options. Distance as well as equipment details can be changed and results can be obtained for any type of truck combinations. The calculations can be implemented for other types of fleet and other hauling material such as Aggregate, GSB, WMM, BC etc. It can be very useful in pre-planning phase of the project and help to save time as well as achieve better economy.
